Project scheduling
On this page
Use Schedule to review construction activities, their dependencies, and upcoming work alongside the rest of your project information.
Availability: Construction scheduling must be enabled for your organization. If you do not see it in the project sidebar, ask your organization administrator to confirm availability. The Schedule under Closeout or in the F&M portal is the separate maintenance schedule.
Import or start a schedule
- Open Schedule in the project sidebar.
- Open More actions (⋯) and choose Import schedule. Select a Primavera P6 .xer or Microsoft Project .mpp or .xml file.
- Choose Keep the file’s dates to retain the dates you received, or Recalculate from logic to derive dates from the dependencies and data date.
- Click Import. When processing finishes, review the activities and any warnings recorded on the import version.
Importing into an existing schedule matches activities by ID: matching activities are updated, new ones are added, and activities absent from the file are removed. Submittal links on matching activities are preserved. Save a version before making a substantial update.
To build a schedule in Specset, click New. Give the activity a name, choose or create its WBS group, and set its timing. WBS groups organize the work into phases or packages.

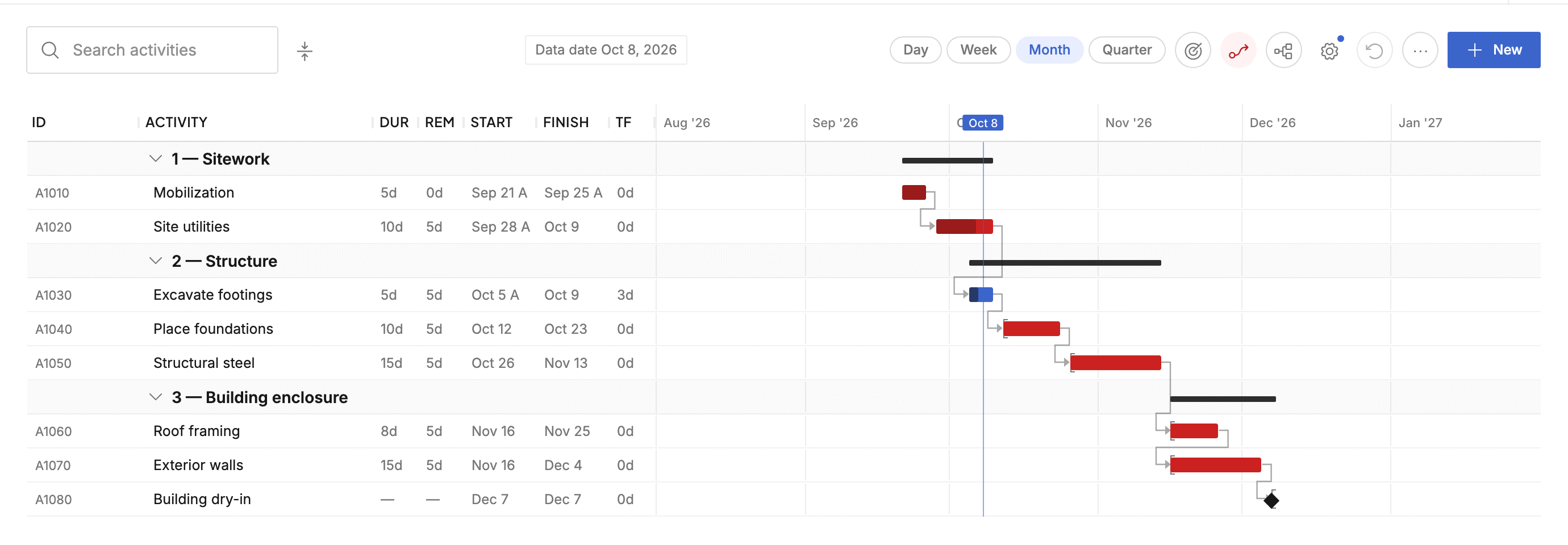

Review dates and dependencies
Use the day, week, month, or quarter view to change the timeline's scale. Select an activity to inspect its dates and links; open its editor to change duration, progress, company, calendar, constraints, or predecessors.
Use Trace logic to follow predecessors, successors, or both for the selected activity. The critical-path and float information helps you identify work that may affect completion. Review imported warnings before relying on a calculation that may differ from the source scheduling tool.
The data date is the point through which progress is reported. Update it through More actions → Set data date when advancing the schedule. Calendars controls working days and exceptions; check those alongside durations when dates look unexpected.
Plan the lookahead
- Open Schedule → Lookahead.
- Choose the start date and a 2-, 3-, 4-, or 6-week window, then click Apply.
- Use Fetch activities to select work from the master schedule.
- Add subtasks beneath an activity and record their progress as the crew completes them.
The master activity bars are locked in this view. Lookahead subtasks break work into smaller commitments without changing the master activity's dates. Make changes to the master schedule in the main Schedule view.
Keep versions and a baseline
Open Schedule → Versions and choose New version to save a snapshot with a useful name and version type. Open a version to inspect it read-only, then return to the latest schedule to continue editing.
In the main schedule, More actions → Set baseline saves the current dates as your comparison point. To use an existing version instead, choose Set as baseline from that version’s actions menu. Ordinary versions remain saved records of the schedule; imports also create versions with notes about anything that could not be reproduced exactly.
Connect submittals and share the schedule
Link the relevant submittals from an activity's details so procurement and approval context stays beside the work it supports. Review linked submittal status when planning that activity.
From More actions, export the schedule as P6 .xer or MS Project .xml, or choose Print to PDF for a review copy. You can also export a saved version from its actions menu.
